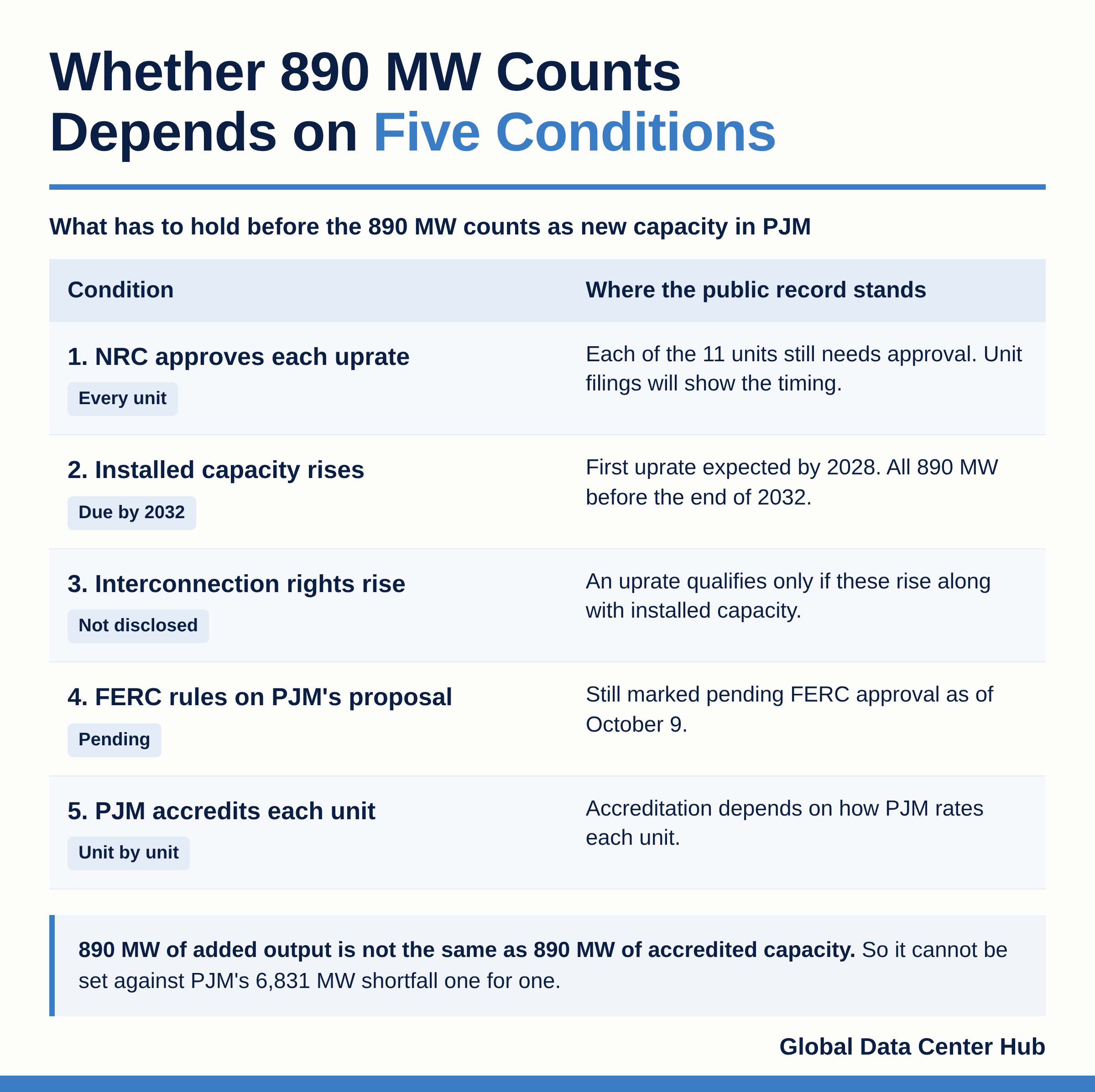

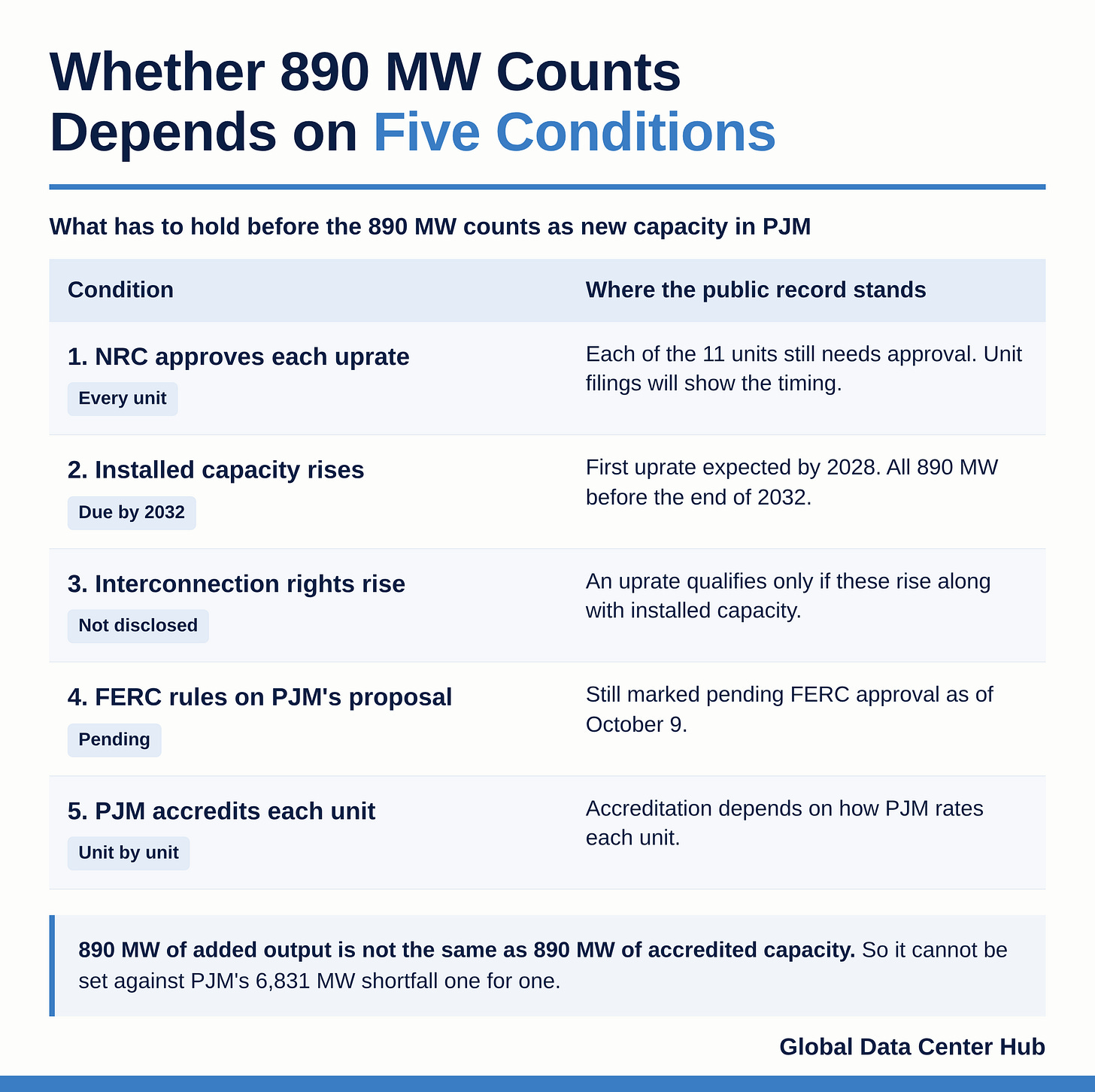

Good piece, and the 890 versus 2,700 split is the right place to start.

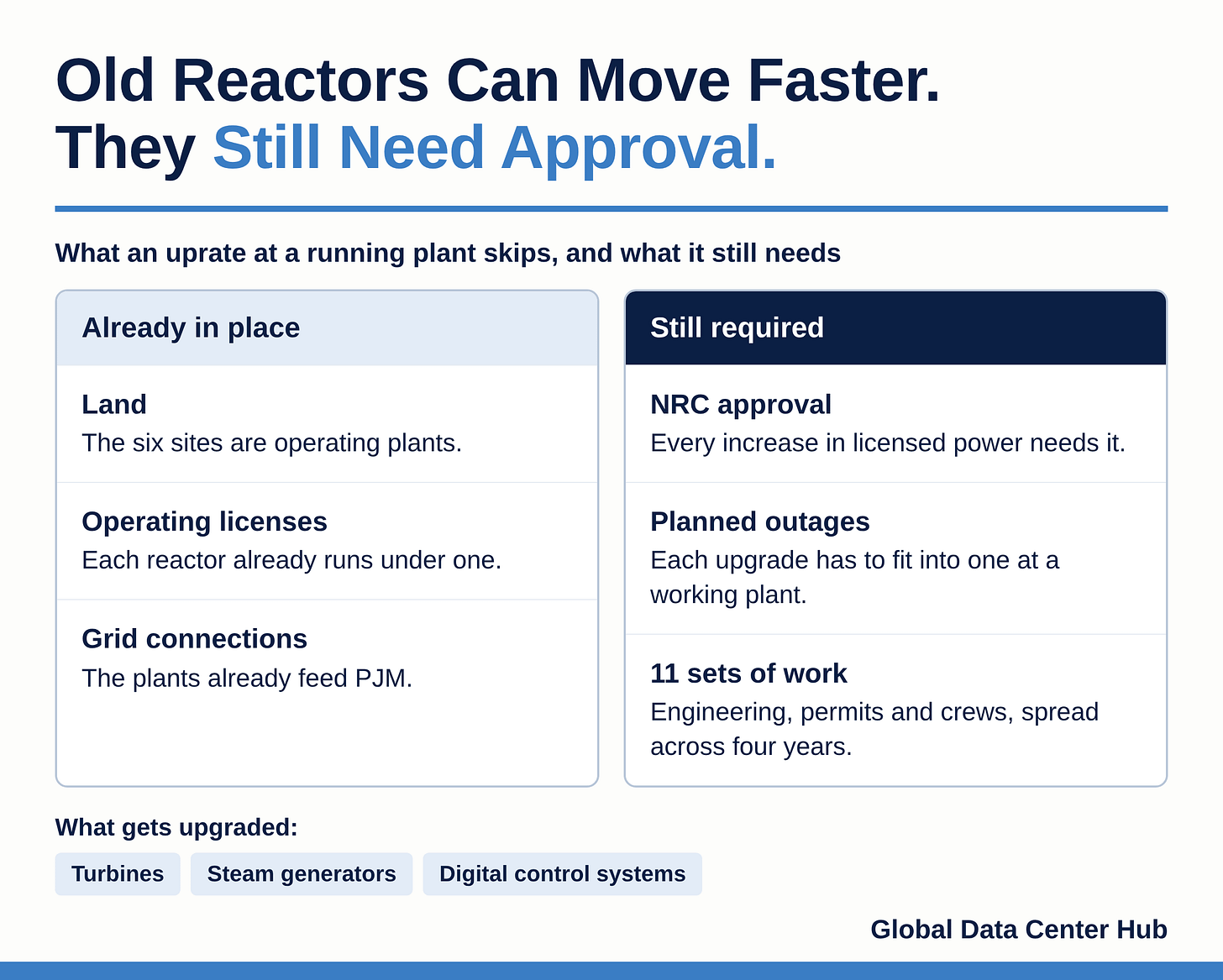

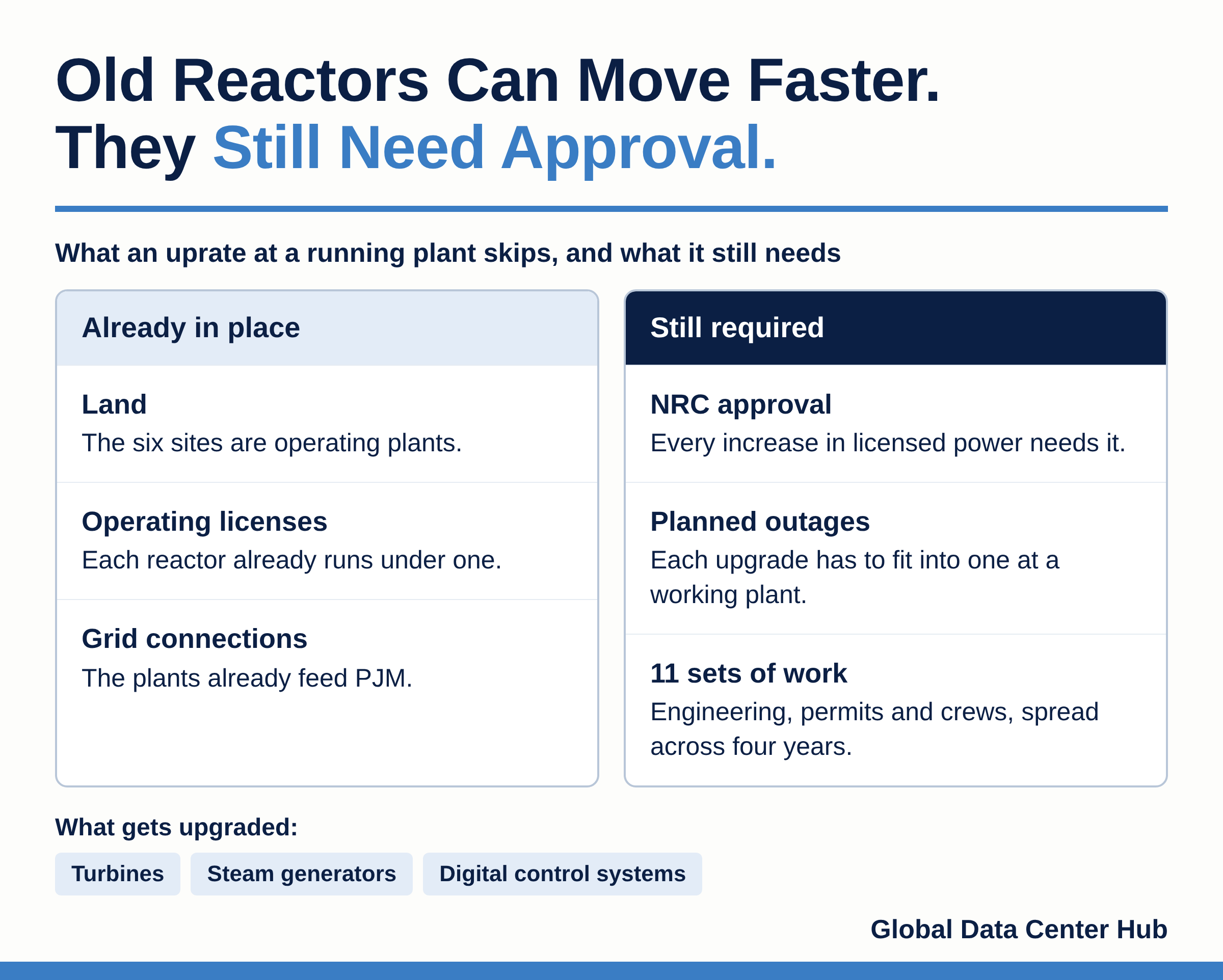

One update since you wrote it. FERC ruled on ER26-3515 on Friday 9 October. It rejected the interim service and the bring-your-own-new-capacity rules and kept only the 50 MW definition and the registry, both effective today. Its reason was jurisdiction: the tariff put obligations on retail customers and chose who gets curtailed, which FERC says belongs to the states. PJM has 30 days to file the stripped-down version. So the two-part uprate test you cite was PJM’s proposal, and for now it’s gone. The contracts signed under it stand.

The market’s answer to your question is already in. I ran the price test on every hyperscaler contract with an existing nuclear plant since Three Mile Island: what did the seller’s stock do on the day? The deals that fund new megawatts moved it: Constellation 22% on Crane and 12% on Google’s upgrades; Vistra 10% on Meta’s. The deals for existing output alone didn’t move it: Clinton flat, Comanche Peak down 4.5%, Dresden down 1.9%. The market paid for the 890, not the 2,700. Your “added or already flowing” test is the one investors have been applying.

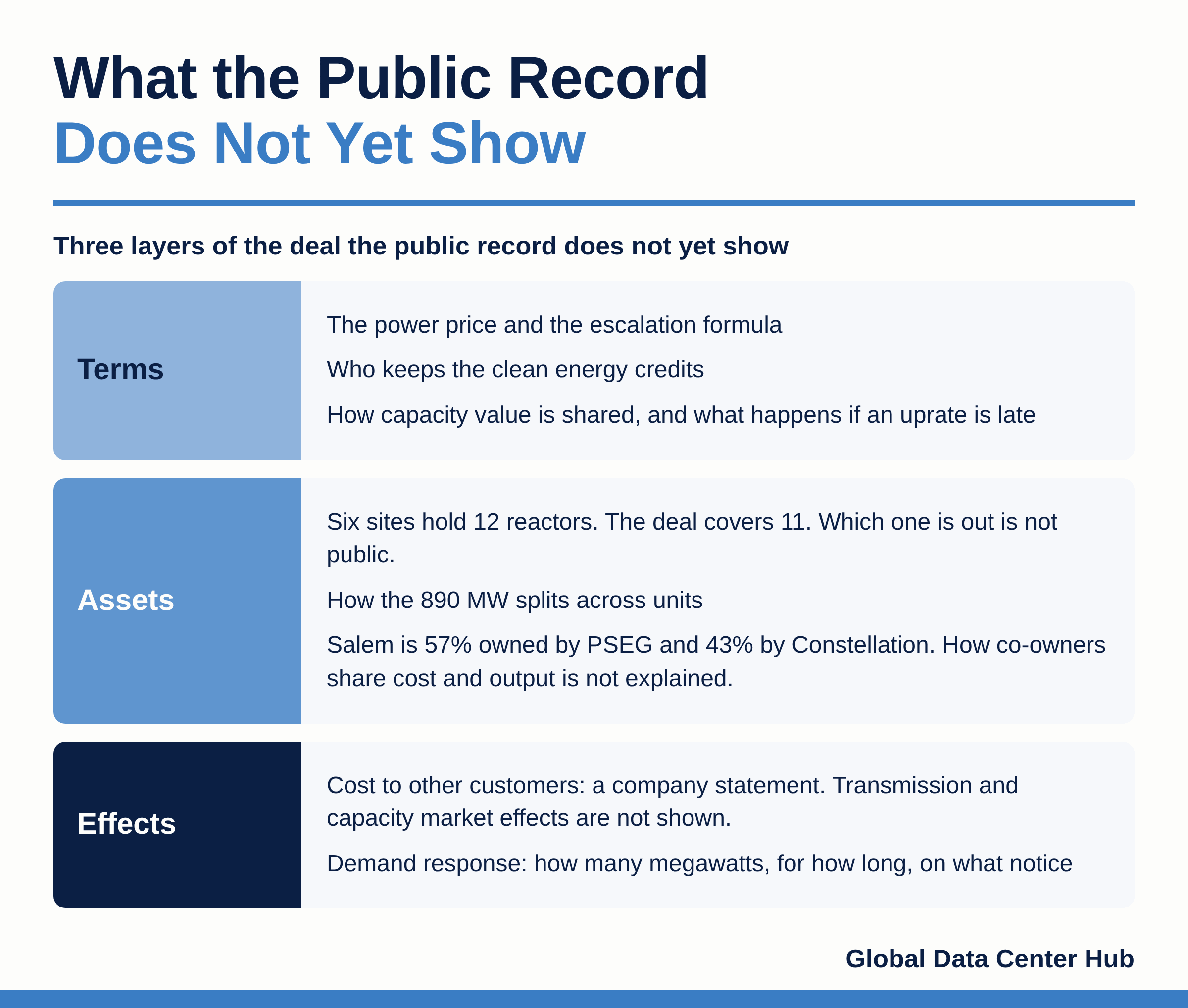

The detail I’d add to your watch list is Salem. PSEG owns 57%. How the co-owners split the $4.3 billion and the new output decide what Constellation’s share of that reactor is worth.

PhronEdge Energy's avatar

What's interesting here is that the story isn't really about finding more uranium or building a new reactor. It's about unlocking additional capacity from infrastructure that's already operating. The next chapter will be regulatory: whether the NRC approves the uprates and how FERC and PJM ultimately treat that capacity. If those decisions go favorably, this could become a template for meeting large-load growth faster than building entirely new generation.
