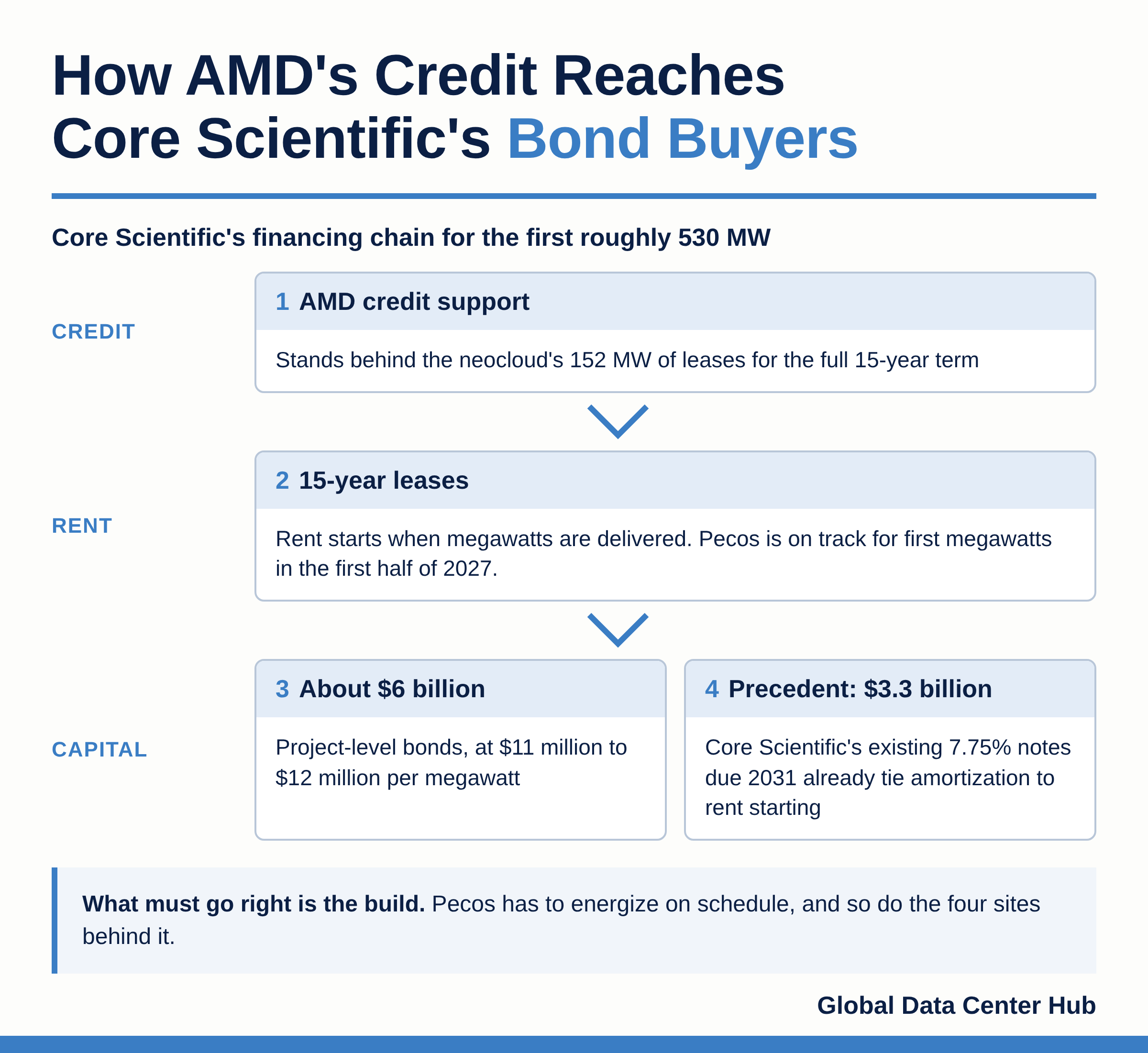

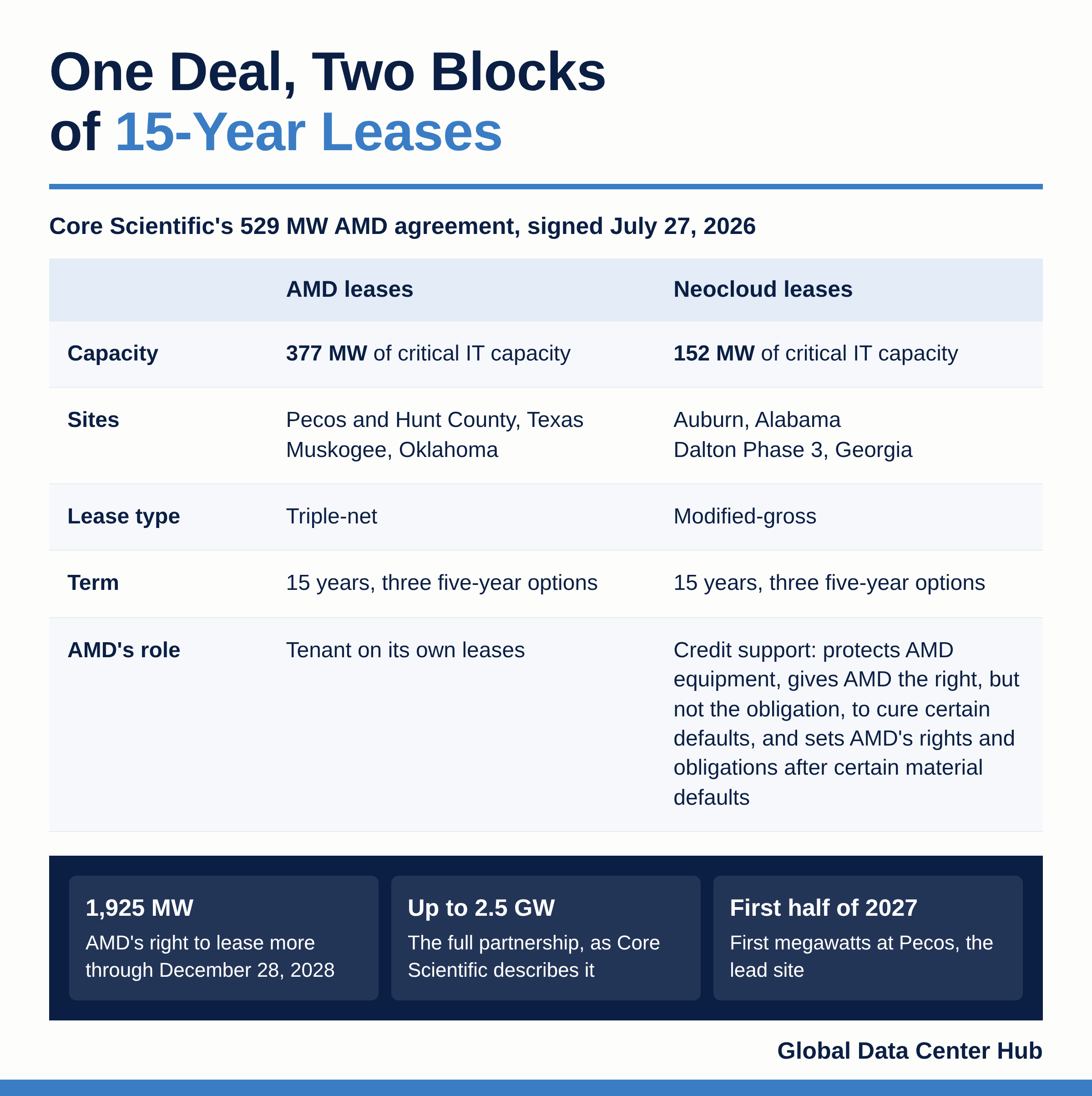

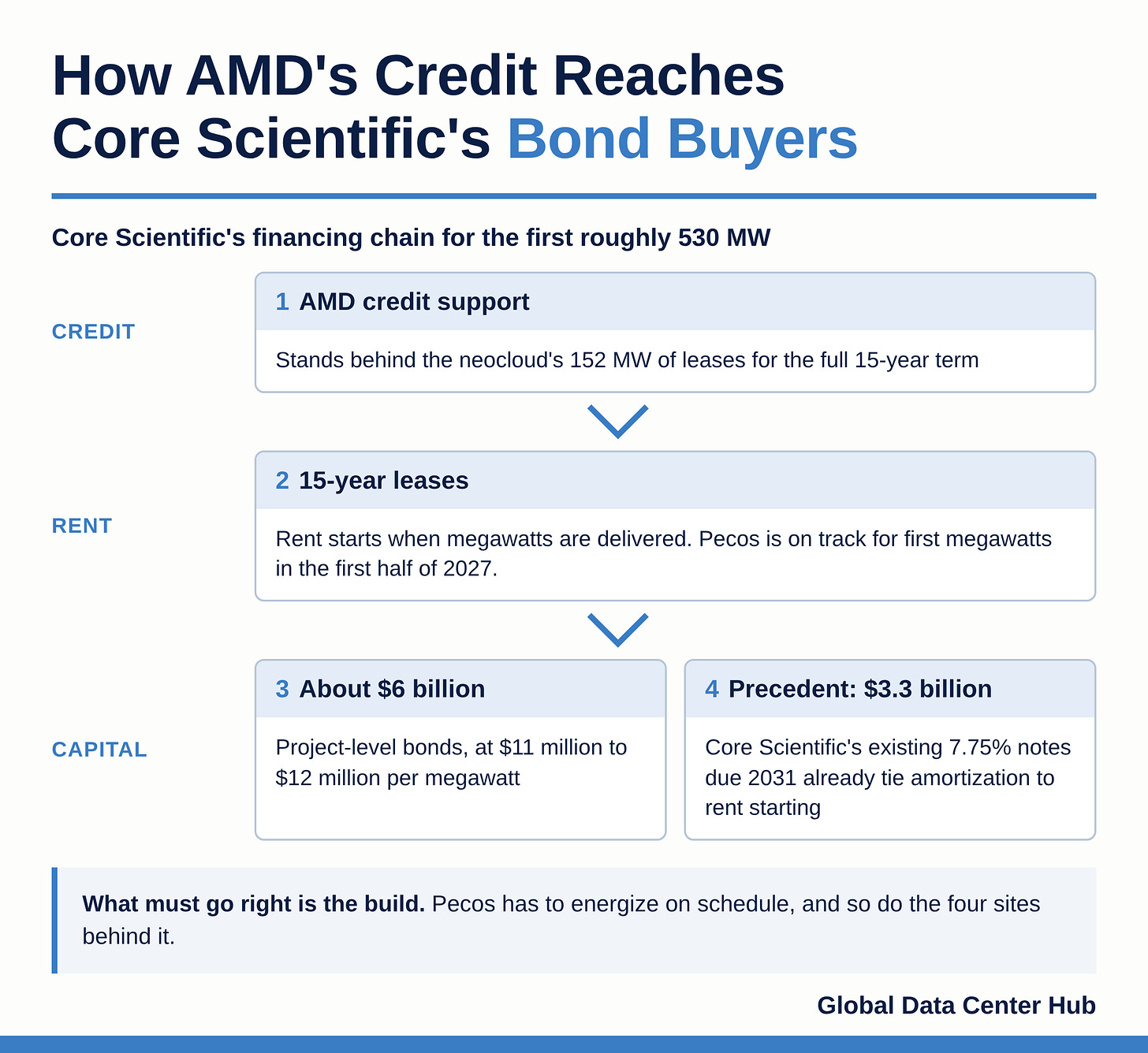

The site mix matters for how this credit support gets tested. Most of AMD's 377 MW sits in Texas, where DC Hub's Data Center Power Index currently bands ERCOT BUILD on both constraint and excess power, while Muskogee falls in SPP, banded BUILD on constraint and CAUTION on excess power. ERCOT's generation queue also holds 453.8 GW across 1,789 active projects (as of Sep 30), so the 1H 2027 first-MW date at Pecos is likely to turn more on local transmission and interconnection timing than on system-wide supply. Source: DC Hub (dchub.cloud), as of Oct 21, 2026.
