Welcome to Global Data Center Hub. Join investors, operators, and innovators reading to stay ahead of the latest trends in the data center sector in developed and emerging markets globally.
This article is the 11th article in the series: Ground to Grid: A Free 21-Lesson Guide to Mastering Data Center Development
Most people assume the servers are the cost. For the developer, the lender, and the infrastructure investor, they are not. The servers sit on the tenant’s balance sheet.
What gets financed as a data center project is power, cooling, and the shell that protects them. The drivers behind those three decide whether the project pencils.
The distinction is structural. A facility amortizes over 15 to 30 years. The GPU payload inside it depreciates over three to five.
In a 20-megawatt AI hall, the hardware can cost $500 million to $1 billion, compared with $200 million to $300 million for the building. The hardware is the larger number. It is not the number in the project finance package.
This is the stage of development where a design becomes a budget someone will lend against. The headline figure matters less than the drivers underneath it.
Where the capital actually goes
A standard air-cooled Tier III facility delivers at $8 million to $14 million per critical IT megawatt in 2026. A fully fitted direct-to-chip liquid facility delivers at $17 million to $25 million.
Global shell-and-core averaged $11.3 million per megawatt this year, up from $7.7 million in 2020.
Power infrastructure accounts for 40 to 45 percent of hard construction costs.
Substation, medium-voltage switchgear, generators, UPS arrays, distribution units, and busway.
This is the category that scales directly with capacity.
Interconnection often sits outside the headline benchmark and rarely stays small.
Core substation equipment for a large campus costs $5 million to $12 million, but switchyards, transmission extensions, protection relays, and transformer bays push the total interconnection cost to $25 million to $60 million.
In PJM, ERCOT, and CAISO, developers also fund off-site network upgrades and post queue deposits reaching $4,000 per megawatt before construction starts.
Cooling takes 15 to 20 percent, and the share is rising.
Chillers, cooling towers, pumping skids, air handlers, and coolant distribution units.
As racks shift to direct-to-chip liquid, mechanical systems' share of the build climbs while electrical and shell both fall.
Shell and site take 12 to 15 percent, with another 4 to 7 percent for site preparation.
Foundations, tilt-up walls, and floor slabs rated for 2,500 to 5,000 pounds per square foot. Land is the variable inside this line.
An acre in Loudoun County or Santa Clara now costs $2.5 million to $4.5 million, compared with $100,000 to $300,000 in Ohio, Indiana, or the Carolinas.
Fit-out, soft costs, and commissioning absorb the remainder.
Design and permitting take 8 to 12 percent. White space containment takes 5 to 8 percent. Fire suppression and security take 2 to 3 percent.
Commissioning takes 1 to 3 percent and moves through five stages, ending with a black-start test that drops utility power and confirms the whole plant carries a simulated load.
The drivers that move the number
Redundancy tier. Tier III delivers concurrent maintainability and 99.982 percent availability, which caps unplanned downtime at 1.6 hours a year.
Tier IV adds full fault tolerance and costs 25 to 40 percent more for identical IT capacity because every path doubles to physically separated rooms.
Hyperscalers do not buy it. They build Tier III and handle software failures across availability zones.
Power density. A GB200 NVL72 rack draws 120 to 140 kilowatts. Next-generation silicon is projected at 300 to 600 kilowatts.
Density sets the cooling architecture, and cooling architecture sets the electrical scale behind it.
Cooling choice. Turner & Townsend puts the construction premium for liquid-cooled capacity at 7-10 percent.
The rack-level hardware carries more: coolant distribution units, manifolds, and cold plates add $30,000 to $75,000 per rack.
Liquid buys some of that back by cutting white space 70 to 85 percent per megawatt, but busway, stainless piping, leak detection, and slab reinforcement consume the saving.
Location. Tokyo builds at $14.30 per watt. Mumbai builds at $6.60. Union trade labor runs $140 to over $200 an hour in New York, Chicago, and San Francisco against $65 to $95 in right-to-work states.
Seismic zones add 8 to 15 percent to structural and mechanical budgets.
Market timing. Large power transformer lead times have grown from 30–45 weeks before 2021 to 120–160 weeks today, with a 30% structural supply deficit and costs up 45–95%.
Reservations now require 15–30% upfront, while schedules have stretched to 24–36 months or more.
On a $1.2 billion campus, a 12-month delay can add roughly $96 million in capitalized interest, pushing contingencies from 5–8% toward 12–20%.
Why cost is measured differently now
Cost per square foot is a real estate metric. It describes floor area, and floor area no longer describes what the asset produces.
Revenue, lease commitments, and valuation all track energized capacity. Cost per critical IT megawatt is the appropriate unit of comparison.
As density rises, cost per rack and cost per unit of compute become the finer measures, because a 120-kilowatt rack and a 10-kilowatt rack occupy similar floor space but represent entirely different capital.
The same nominal facility can carry a 3x cost range depending on tier and density alone.

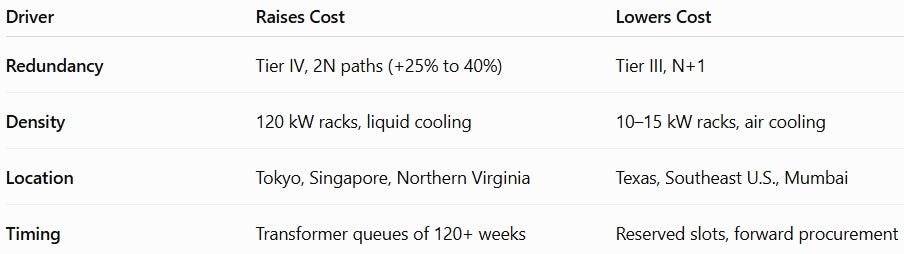

Which direction each driver pushes
What this means for each party
For developers, tier and density are choices; the equipment market isn’t. Forward procurement is the only step you can take before signing a lease, but it requires 15–30% of equipment value upfront. Commit too early, and you risk leaving gear unused; wait, and you may miss your delivery date.
For investors, ask about the tier, density, market, and whether transformer and switchgear orders have been placed. Two builds at the same cost per megawatt can carry very different risk, often revealed by the completion date. A 5–8% contingency may signal the sponsor hasn’t repriced for today’s equipment market.
For operators, these choices shape costs for the asset’s life. Industry-average PUE is 1.54, while leading sites reach 1.10–1.20. For a 50 MW facility, that gap can mean roughly $10 million more in annual power costs. Electricity accounts for 40–60% of opex, potentially matching or exceeding the original build cost within five years.
For policymakers, equipment supply is a constraint that incentives cannot bypass. Lagos costs $12.00 per watt, compared with $11.20 in London, largely due to limited domestic manufacturing. Tax breaks reduce costs at the margin; local manufacturing lowers them structurally.
Which cost driver do you think is most underestimated in early budgets, and which one has surprised you most on a real project?
