Welcome to Global Data Center Hub. Join investors, operators, and innovators reading to stay ahead of the latest trends in the data center sector in developed and emerging markets globally.
In Q3 2026, AI labs signed some of the largest data center contracts of the year. The company signing for capacity was often not the one owning the campus, raising the debt or backing the payments. If you build, lend to or invest in this market, that changes the questions you need to ask.
New Buyers, More Backers
AI labs became direct buyers of data center capacity in Q3 2026. Anthropic agreed to about $45 billion of capacity over six years with Nscale.
OpenAI announced a $20 billion campus of its own in Georgia and is the named customer for 8 GW at SB Energy’s PORTS-Pike campus in Ohio.
The money around them came through more hands than before. Banks lined up $15 billion for an Anthropic campus in Texas, with Google’s credit rating standing behind Anthropic.
Nvidia gave credit support at PORTS-Pike and set a $500 billion financing target with six of the largest investment firms. In El Paso, BlackRock became majority owner of a Meta campus while Meta kept a guarantee on part of its value.
I read this as good news for capital formation. More partners make money easier to raise. The open task is to widen the base of demand behind that money, because many of these structures still lean on a small group of labs and suppliers.
Most of the capital in this quarter’s list is also attached to capacity that is still being built, powered or contracted. For you, the opportunity is real, and so is the work of checking what each commitment actually covers.
How to Read This Quarter

Five Structural Trends
1. AI Labs Became Direct Buyers
Anthropic with Nscale in West Virginia. OpenAI in Effingham County and at PORTS-Pike. OpenAI again through Firmus in Asia-Pacific. The labs signed for capacity directly, and one report in the dataset put Anthropic’s compute deals at $517 billion over 11 months.
They were not the only buyers: Google, Meta, ByteDance and SK Telecom all committed capital too.
The labs also want capacity sooner than gigawatt campuses can deliver it, and both OpenAI and Anthropic were reported to be seeking 20 to 30 MW sites in the meantime. If you own ready capacity at that size, you are in a good position this year.
2. More Partners Now Stand Between the Tenant and the Money
The company using a data center is often not the one owning it, borrowing for it or backing its payments, and those roles are not interchangeable. Nvidia’s $500 billion platforms are a fundraising target.
At PORTS-Pike, Nvidia gave formal credit support on land, power and shell. On the Nexus loan, Google backstopped Anthropic with its credit rating. In El Paso, BlackRock became the majority owner while Meta kept a residual value guarantee.
Each of these moves a different piece of risk. If you lend into this market, “who is the tenant?” is no longer enough. Your question is which payments are supported, by whom, on what conditions, and which risks stay with the project.
3. Bitcoin Miners Became AI Landlords
Hut 8, Bitdeer and CleanSpark signed long-term AI leases. Riot reached a deal with Anthropic, IREN added $2.8 billion in contracts, and Core Scientific agreed to give AMD access to more than 500 MW.
The miners spent years assembling power and land, and in Q3 several turned those sites into AI leases running 16 to 20 years.
The value depends on conversion: cooling, network links, reliability, and the cost of meeting AI customers’ specifications. Where those line up, this is one of the quickest routes to powered capacity.
4. Local Policy Moved Into the Financing
States are setting clearer rules for large data centers, and the approaches differ. New York paused new state permits for hyperscale projects of 50 MW or more for one year.
Texas paused grid-connection approvals for new data centers while regulators review a queue of about 474 GW of proposed demand, roughly 90% of it from data centers.
Pennsylvania made its development standards mandatory and tied state permits to local approval, without a moratorium. These rules give developers a clearer path, and they also feed into financing.
Some lenders are already factoring permitting timelines into how they price construction debt. If you are planning a campus, your permitting plan is now part of your financing case.
5. Resilience Became Part of Site Planning
The Gulf remains one of the fastest-growing data center regions, and this year it also showed why resilience planning matters. Regional security events affected some facilities, and AWS advised some customers in Abu Dhabi and Bahrain to consider alternatives while repairs continue.
Investment kept coming. Microsoft framed its $10 billion Gulf strategy around resilience, Microsoft confirmed its Saudi Arabia East region for November 2026, AWS and Humain committed to 50 MW in a Saudi AI zone by 2028, and Humain is seeking $2.5 billion for new capacity.
If you are building or financing in the region, redundancy and physical security now sit next to power and land in your plan.

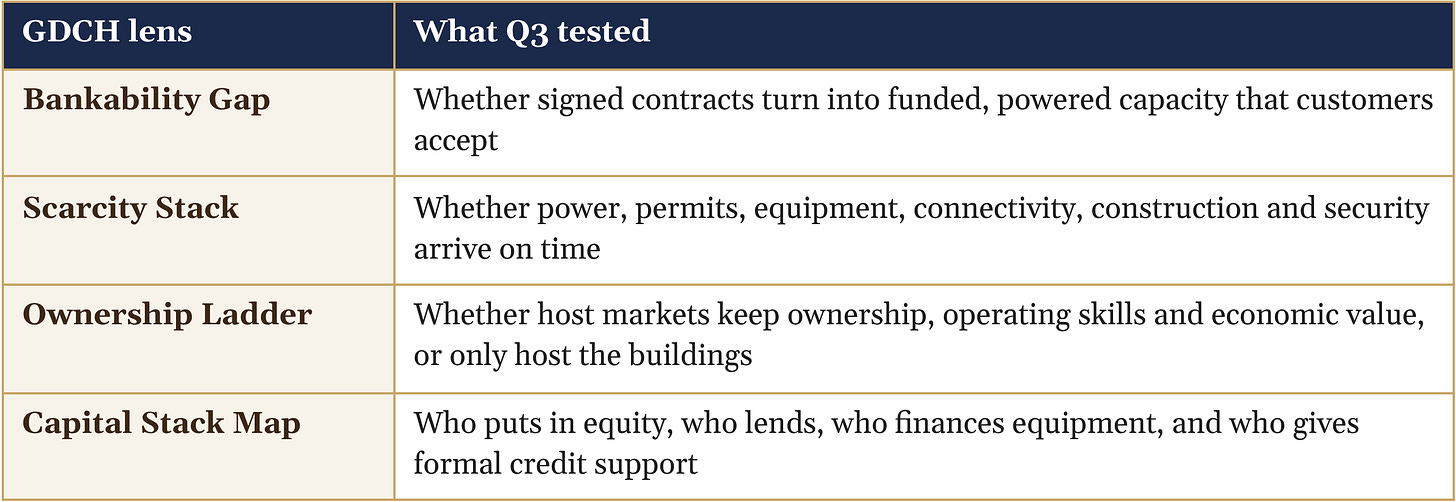

Where the 12 Announcements Stand

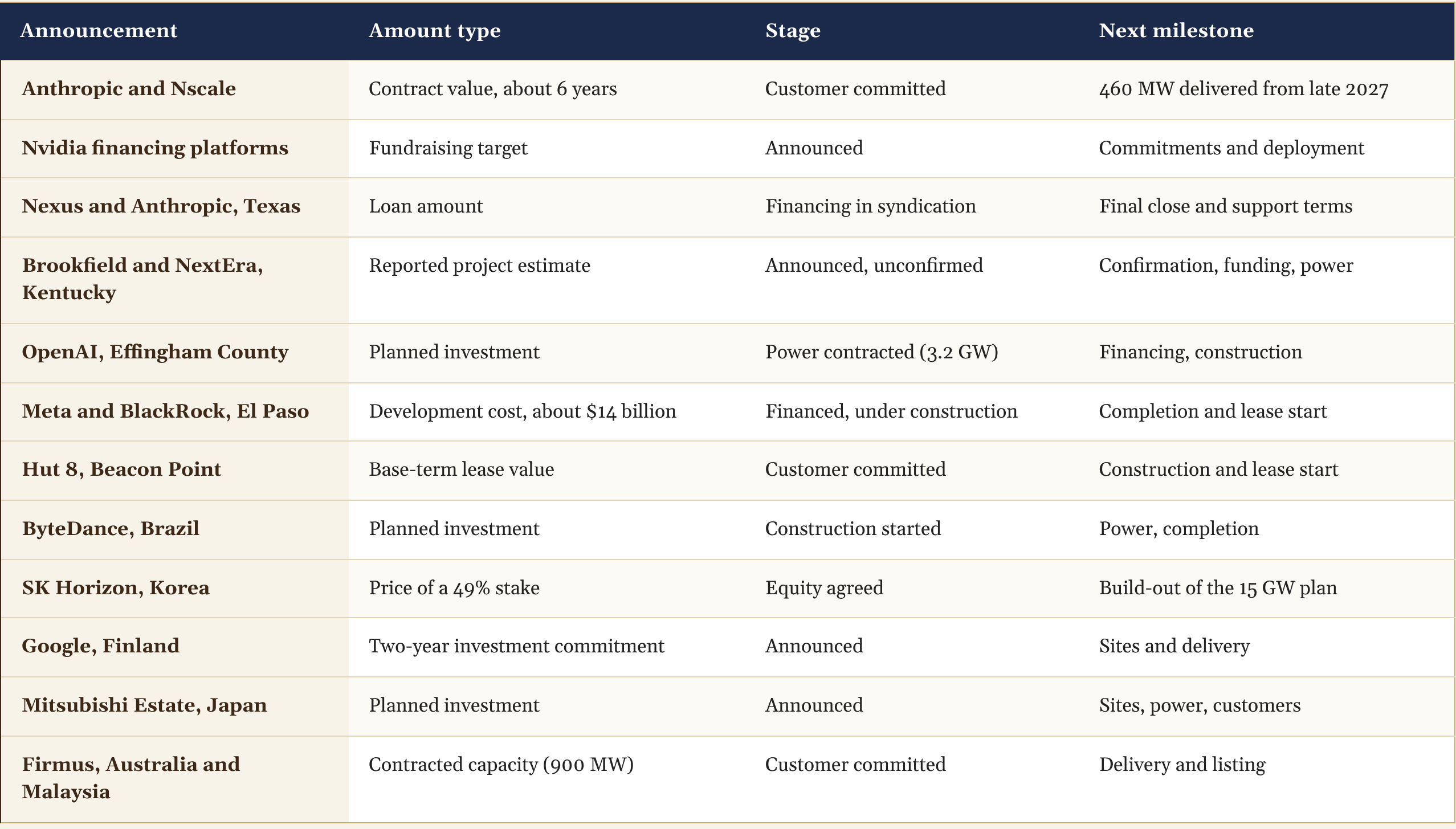

Capacity moves through stages: announced, site controlled, customer committed, power contracted, financed and under construction, energized, and finally accepted and earning revenue. The dollar figures in this list sit at very different points on that path, and knowing which point helps you compare them.
Below: five openings for lenders, builders and investors, five risks to plan for, what would change my view next quarter, and the full ranked list of the quarter's top 12 announcements.
