Fiber & Connectivity Bottlenecks (Part 2): How to Evaluate Dark Fiber Availability Before Acquiring Data Center Land
A step-by-step playbook to avoid stranded assets, missed timelines, and ROI-killing connectivity delays in the AI era.
Editor’s Note:
This is Part 2 of a two-part series on one of the most overlooked risks in AI infrastructure: fiber.
In Part 1, we explored why fiber bottlenecks, more than power, are threatening to derail the next wave of AI-driven data center investment.
Here, in Part 2, I walk through the practical framework top investors and operators are using to evaluate dark fiber availability before they commit to land, power, or permitting.
The Power-Fiber Blind Spot
In 2025, most data center investors know they need power and land.
But there’s a third leg of the stool that’s quietly derailing projects, blowing budgets, and killing returns:
Fiber.
More specifically, access to scalable, diverse, and low-latency dark fiber.
If you’re selecting data center sites based on land and power, but not fiber, you’re not just missing a detail.
You’re taking an eight- (or nine-) figure bet with a blindfold on.
This article gives you a battle-tested, investor-ready system to:
Map fiber availability
Evaluate route redundancy
Estimate build-out timelines
Avoid dead zones
And protect your IRR from the #1 hidden risk in digital infrastructure.
Why Fiber Has Become the New Bottleneck
Everyone’s talking about power grid delays. But fiber is the silent killer.
AI workloads need 10x more fiber than legacy compute
Lead times hit 60 weeks during the 2022–23 crunch
Fiber prices surged 70% between 2021–2024
Many secondary markets have no usable dark fiber nearby
Even well-powered sites are functionally stranded without connectivity
You can’t run generative AI clusters, or even basic GPU workloads, without high-density, low-latency, redundant fiber.
And yet, fiber diligence is still missing from many investor site selection models.
That stops here.
The 5-Step System to Evaluate Fiber Before You Buy
This is the exact framework used by sophisticated capital when evaluating data center land across global markets.
If you apply this rigor up front, you can eliminate 50% of unsuitable sites, before spending on studies, deposits, or negotiations.
Step 1: Overlay Fiber Maps in Your Initial Site Screen
Before power, before price per acre, before tax incentives, ask one question:
Is this site within 5 miles of high-capacity dark fiber?
Use tools like:
Commercial fiber mapping platforms (e.g., Lightyear, Cloudscene, InfraMaps)
Local IXPs and carrier-neutral facilities
Conversations with regional telecom providers and municipalities
Key filters to apply:
Does the route offer dark fiber, not just lit services?
Is there provider diversity or a single incumbent?
What’s the estimated strand count available?
Red flag: “Fiber nearby” often means lit-only, low-capacity loops controlled by a single provider. That’s not scale-grade.
Step 2: Score Carrier Density and Route Redundancy
AI workloads are hypersensitive to jitter, latency, and network interruption.
That means fiber isn’t binary. It’s graded based on availability, quality, and diversity.
Ask:
Are there two or more dark fiber providers with network presence at the site or within trenching distance?
Do routes offer geographic separation (e.g., diverse conduits and entry paths)?
Can you secure non-discriminatory access and negotiate IRU terms?
If you only have one path out, your AI tenant won’t meet its SLA. And neither will you.
Step 3: Estimate Time and Cost of Route Extension
If the site is 3–10 miles from the nearest dark fiber loop, you don’t have to reject it, yet.
But you do need a precise sense of what you’re facing:
Contact providers for make-ready cost estimates
Request construction timelines, permits, and rights-of-way status
Review crossing agreements, easements, and municipal trenching requirements

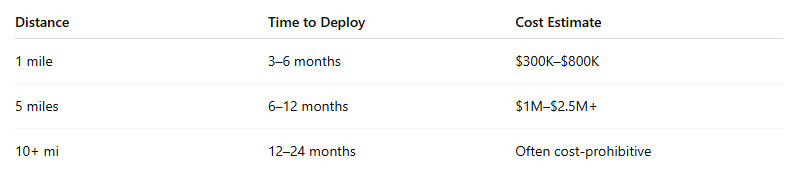

Typical estimates:
Important: Costs are rising. Inflation in conduit, permitting, and labor can easily derail pro forma assumptions if not modeled upfront.
Step 4: Vet for Subsea, Long-Haul, and DCI Connectivity

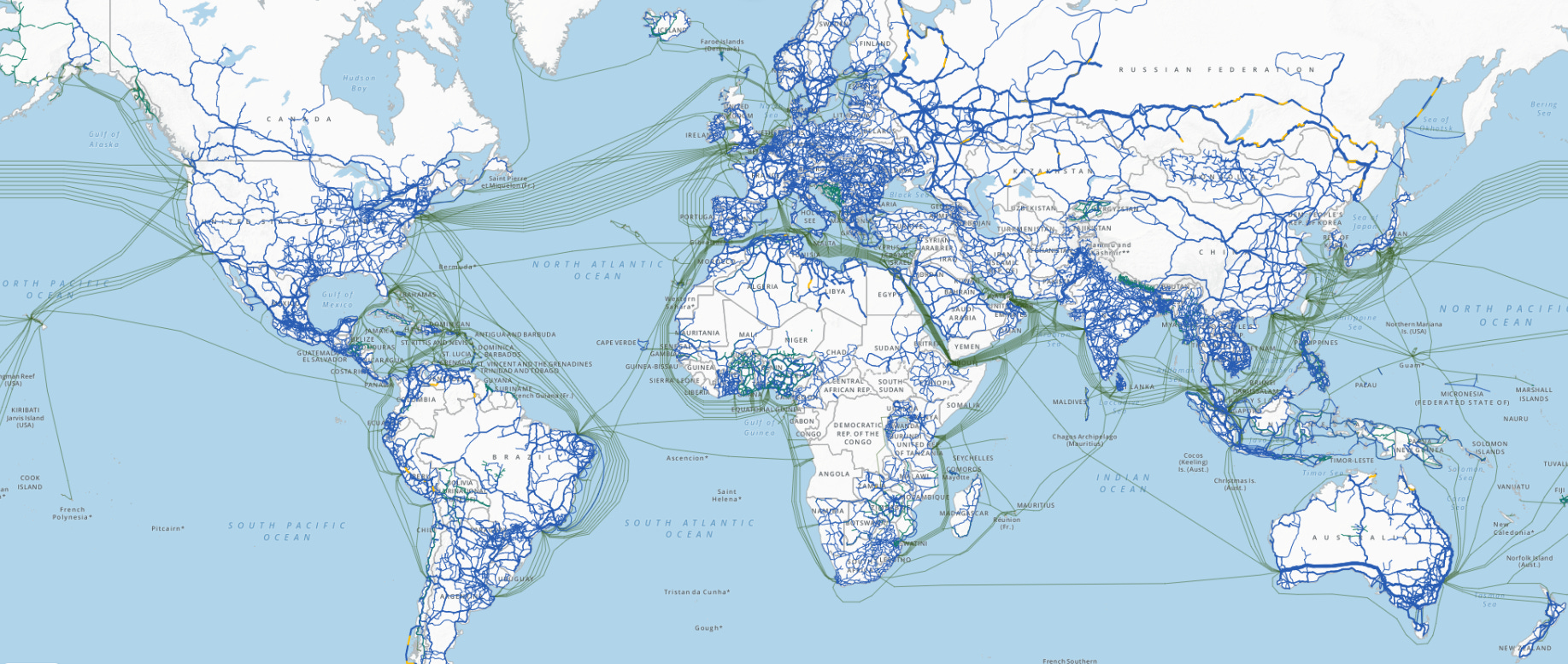

For global AI infrastructure and inter-region training workloads, proximity to:
Submarine cable landing stations
Long-haul fiber backbones
Interconnection hubs (IXPs, meet-me rooms)
…is non-negotiable.
Use regional maps, subsea cable consortium data (e.g., TeleGeography), and hyperscaler partnership announcements to guide diligence.
Sites more than 100–150 miles from a landing point or interconnection hub may struggle to meet international latency requirements.
Step 5: Plan for Long-Term Control with Dark Fiber and Supply Agreements
The final step isn’t about access. It’s about control.
If you want your infrastructure to scale with AI workloads, you need:
Indefeasible Rights of Use (IRUs) for long-term capacity
Multi-year supply agreements with vendors like Corning, CommScope, STL
Participation in buildouts through co-investment or pre-sales
Optional: Metro dark fiber acquisition or leasing via regional ISPs
Smart capital is locking in 10–20 year rights with scale clauses, backhaul guarantees, and performance SLAs. Treat fiber like power: buy it before the next wave arrives.

Fiber Diligence Summary Table
Why This Playbook Matters Now
Power grabs attention.
But fiber determines who actually wins the compute race.
McKinsey projects data center demand will triple by 2030.
Hyperscalers are already buying 24–48 fiber pairs per route.
AI latency budgets are measured in microseconds, not milliseconds.
If your site doesn’t connect to the right fiber at the right capacity, it won’t matter how cheap the land is.
It’s not a data center location.
It’s a stranded investment.
Final Take: Fiber Is the New Due Diligence Priority
In this cycle, the winners will be those who treat:
Fiber like power
IRU contracts like PPAs
Route maps like zoning overlays
Interconnection like currency
If you want to build, scale, and exit data center assets in the AI age, integrate fiber mapping into your site selection on day one.
Because in 2025 and beyond?
Fiber isn’t a utility.
It’s a moat.
